Project Update 11/07/2025
From "Coundon Burn Sewer"
Go to the project
Hi everyone,

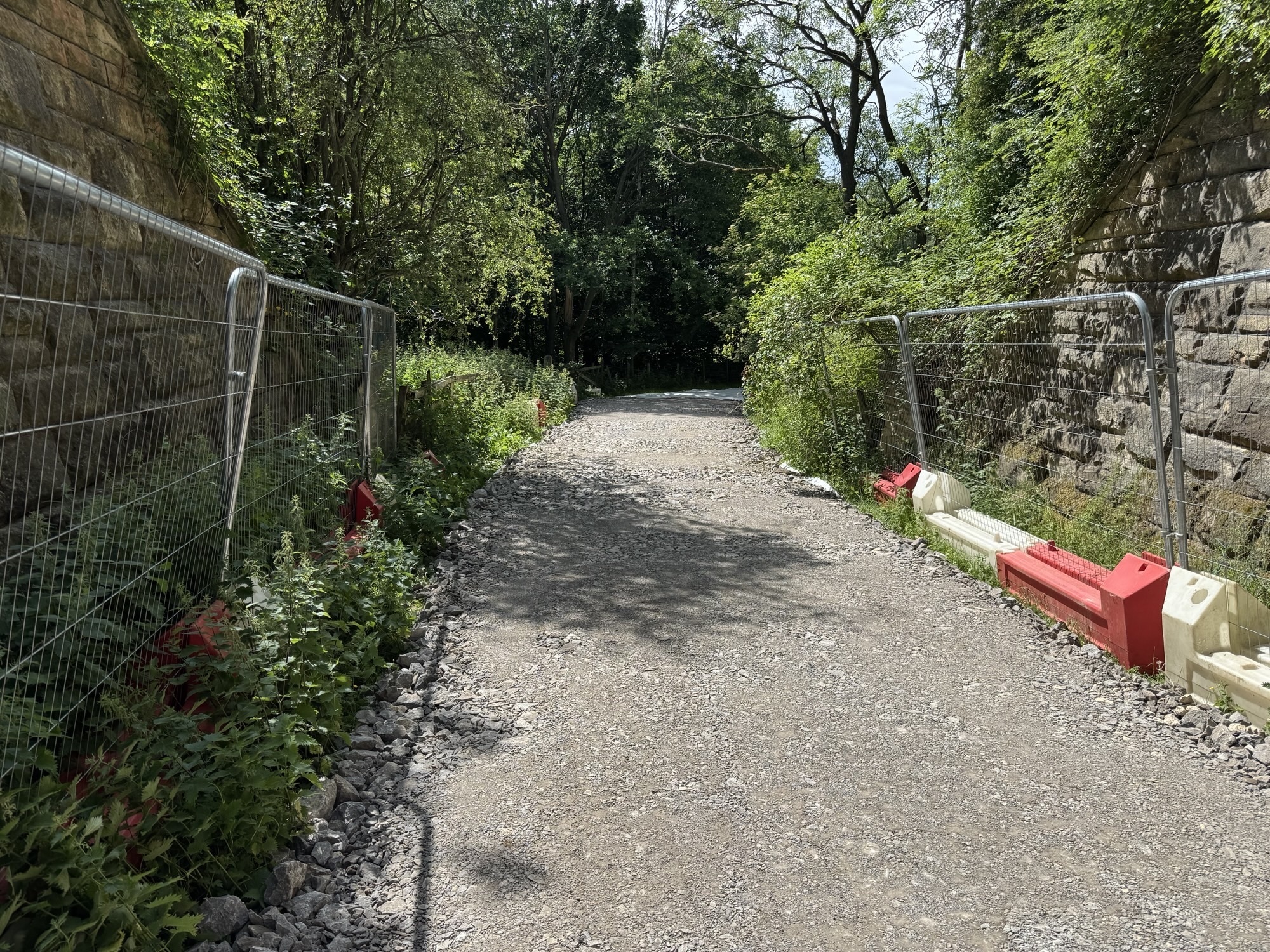

All compound and haul roads have now been installed, except for the Western most haul road off Dial Stobb road, which we are looking to complete by the end of next week.

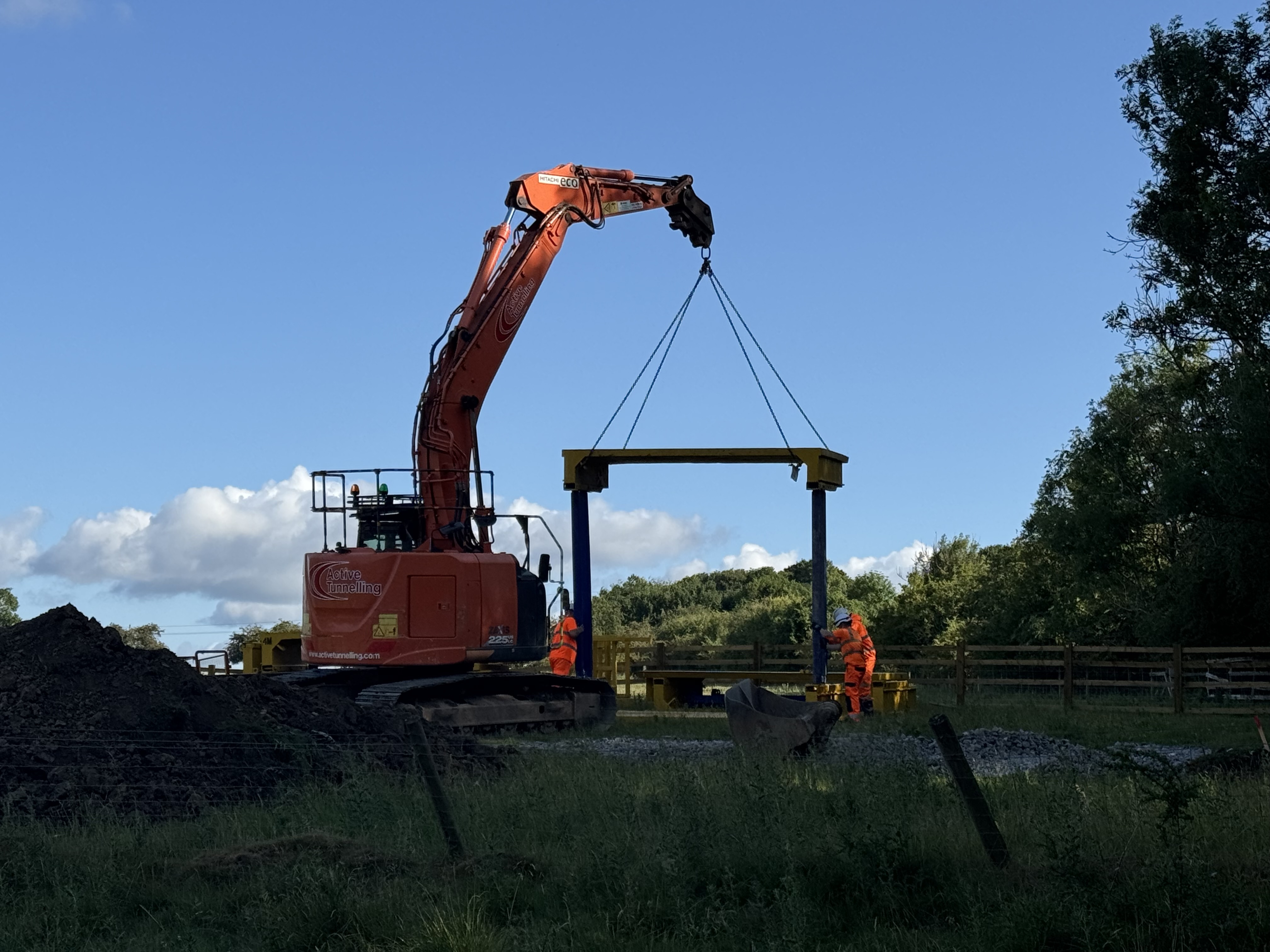

Active tunnelling is on site and have excavated the first two driving pits ready for the tunnelling team to start Tuesday15th July.
Esh Drainage Solutions have attended site to check flows and CCTV the full drainage system, in anticipation of starting the lining works on Monday 21st July.
Should you have any questions please comment on this page or contacts us at NWL.Customer@esh.uk.com.
