Project Update 26/08/2025

From "Coundon Burn Sewer"

Go to the project

Hello everyone,

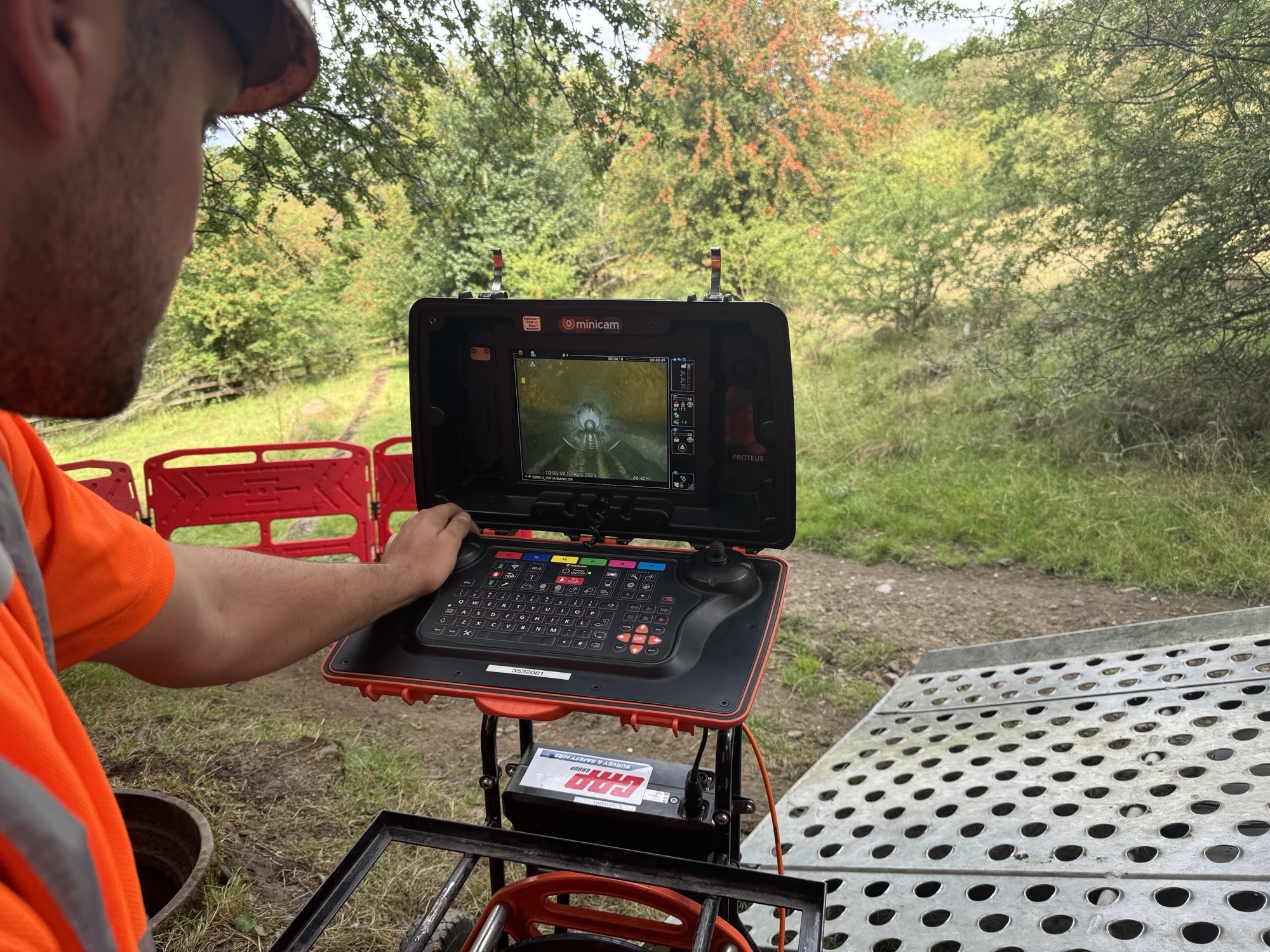

We are approximately 60% complete with the auger bore works and are expected to complete these works within the next couple of weeks.

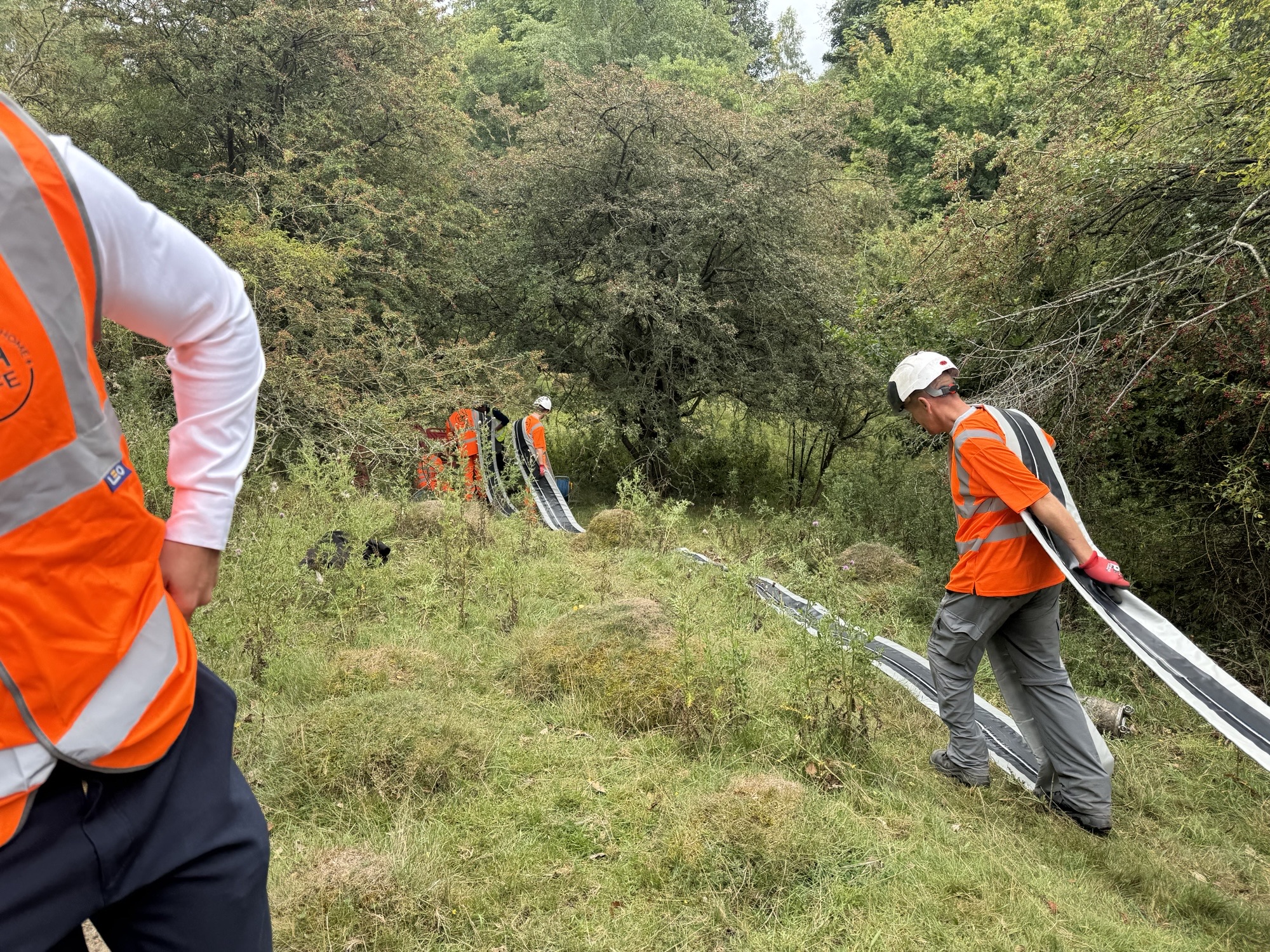

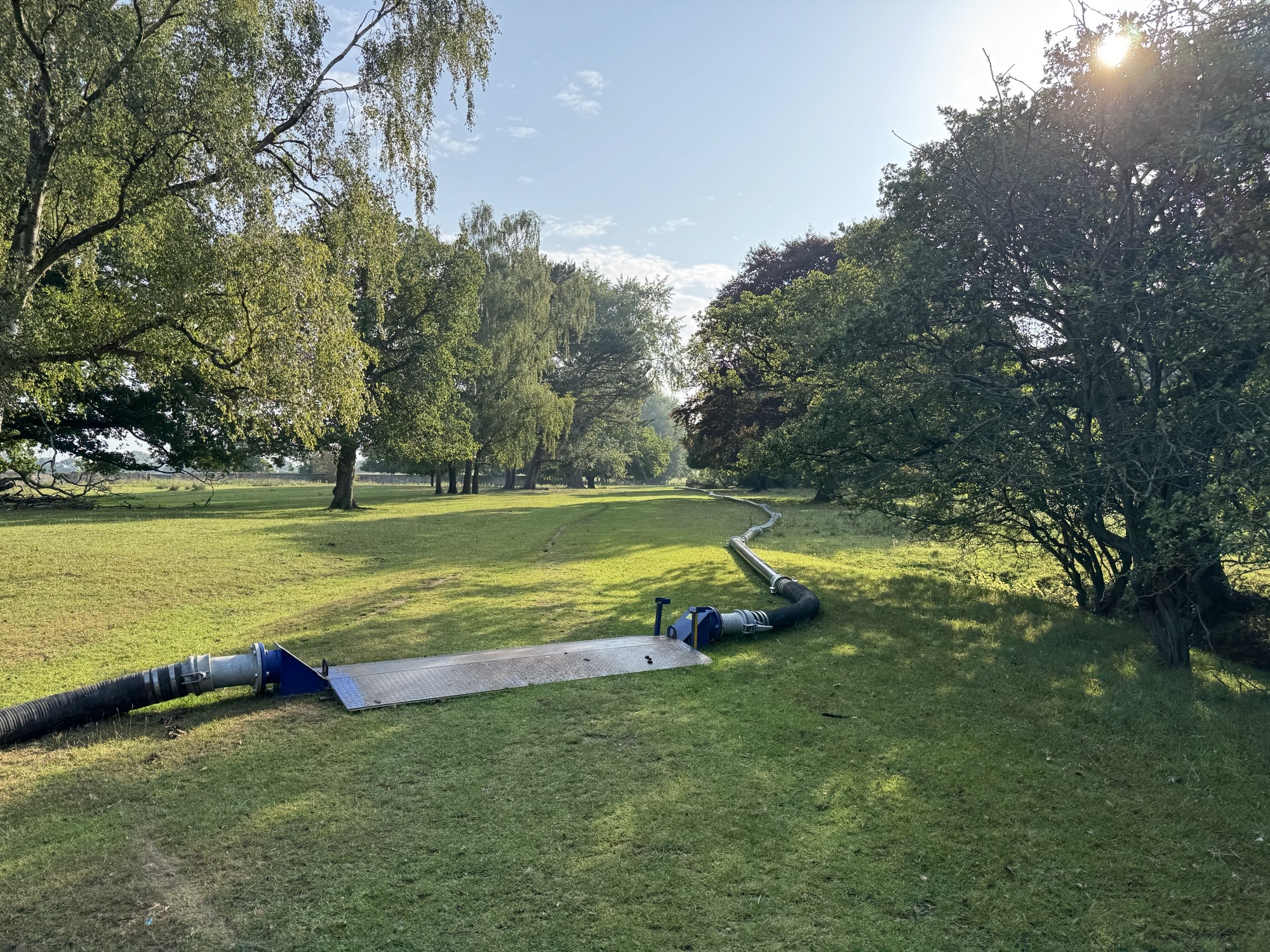

Esh Drainage Solutions are also around 60% complete with their lining works. The over-pumping system is currently being relocated from Phase 1 to Phase 2, and lining works are scheduled to recommence early next week.

The team have now also installed three manholes and are now preparing for the excavation of the attenuation tank. Excavation is planned to begin later this week.

Should you have any questions please comment on this page or contacts us at NWL.Customer@esh.uk.com.
