Hello everyone, an update for you all on Coundon.

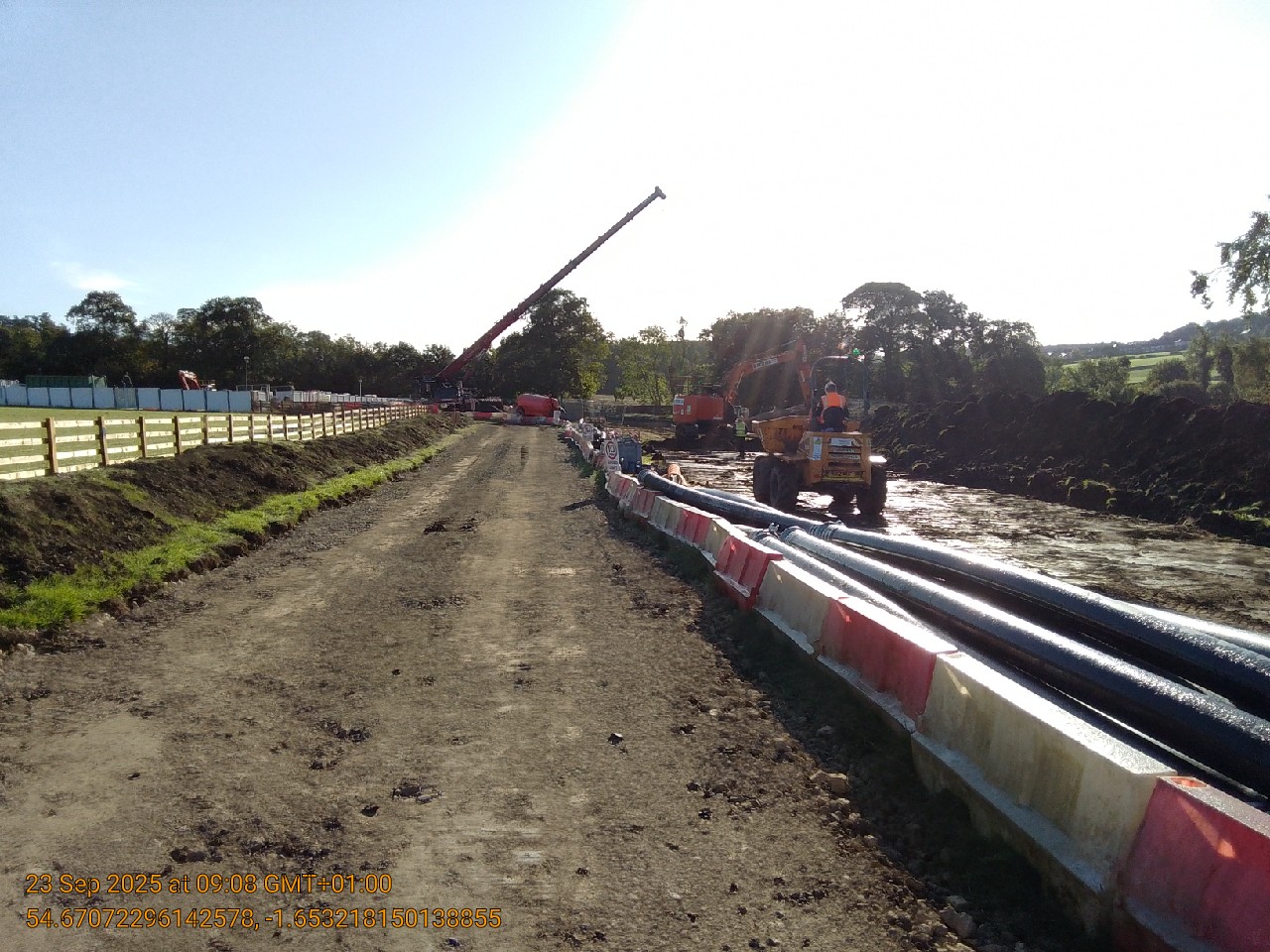

We are due to complete installation of manhole 5 and manhole 6. We then need to complete the topsoil strip for the full drainage run from manhole 6 to the attenuation tank. We are also due to commence installation of the drainage run between manhole 6 to manhole 7.
Esh Drainage Solutions have completed all re-lining works. All over pumping will be removed by the end of this week.

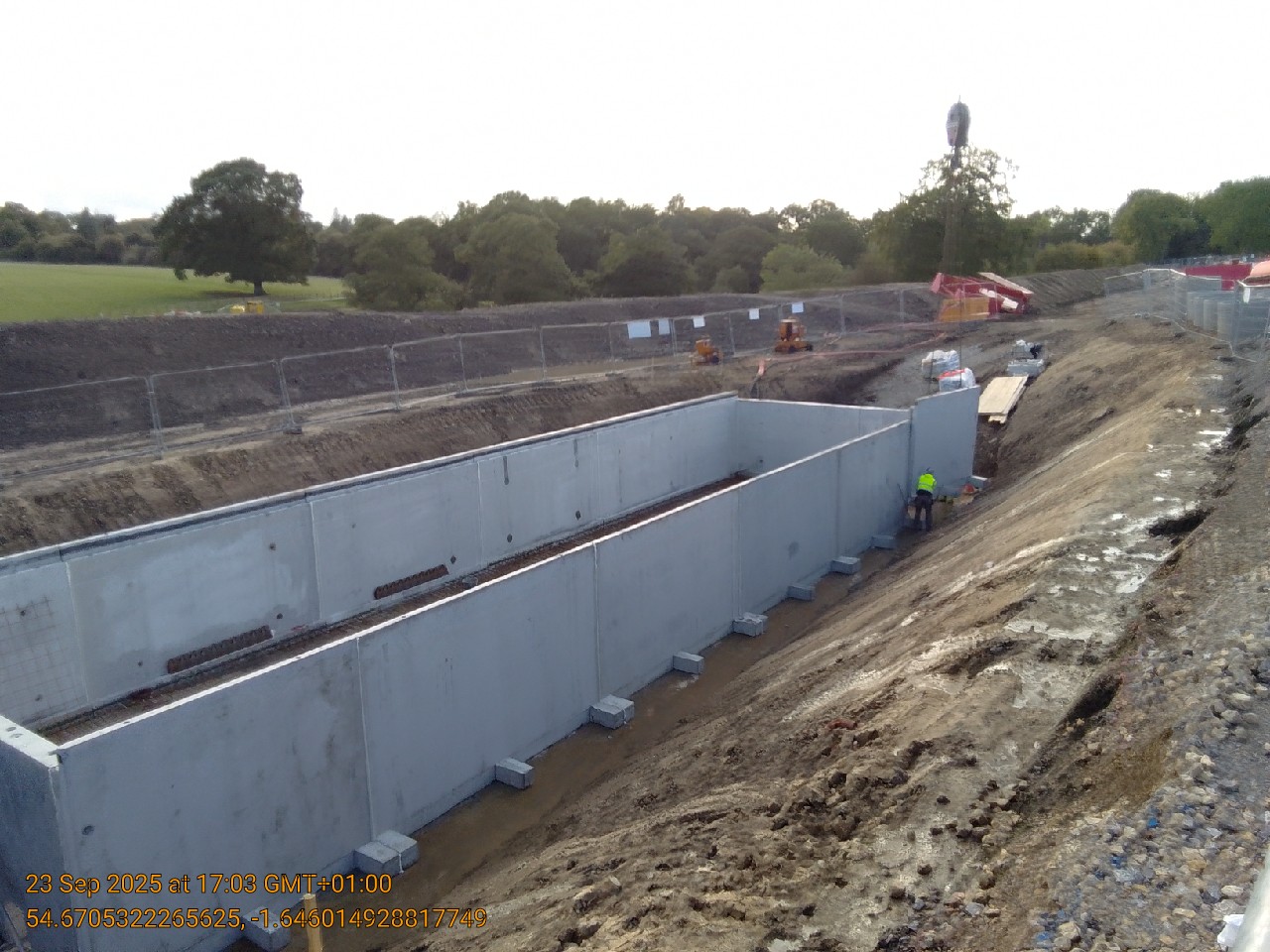

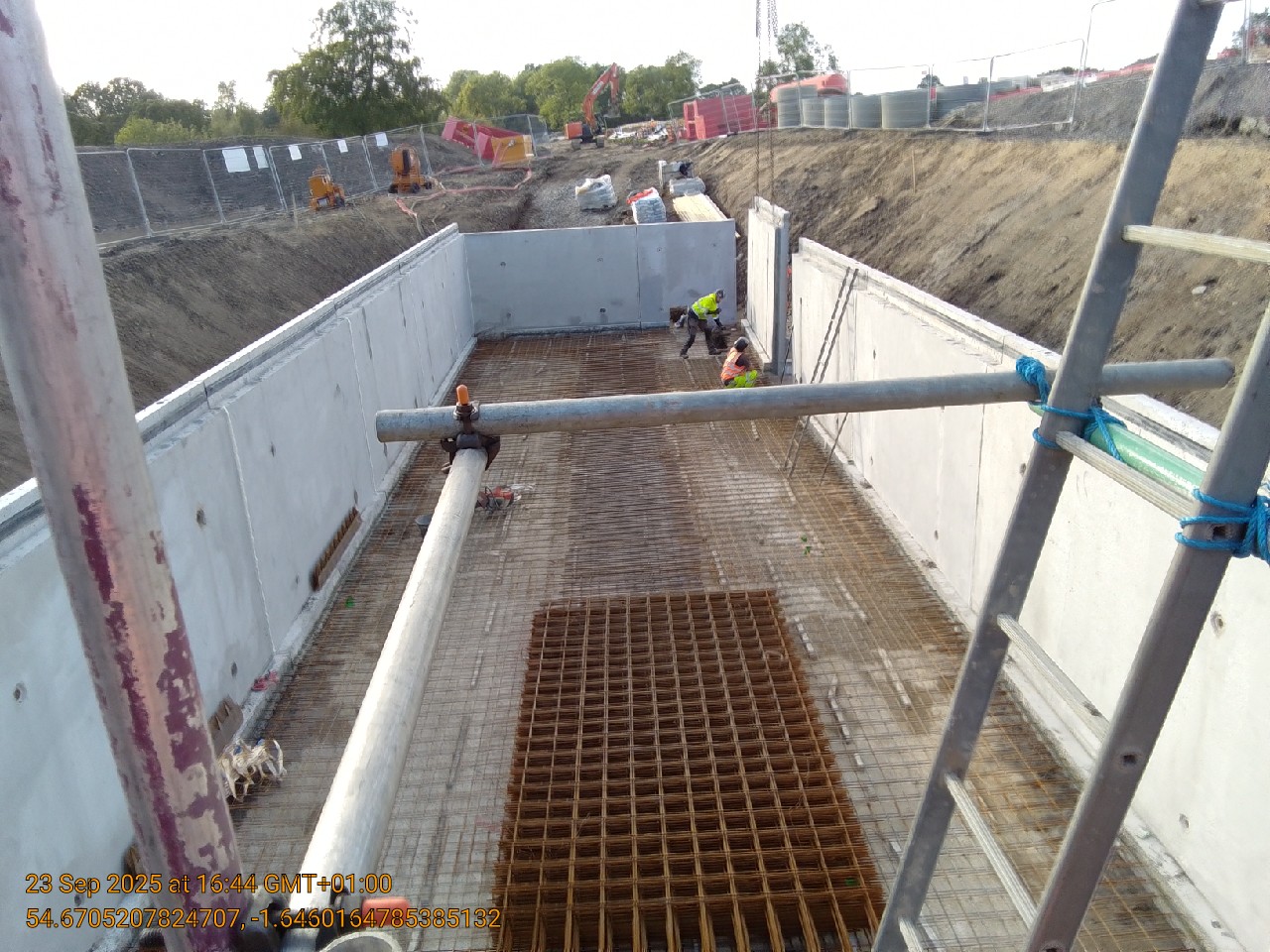

We have completed the installation of blinding concrete to the base of the attenuation tank excavation and will be taking delivery of the precast concrete walls to begin installation of the attenuation tank.
Next week, we are due to commence site mobilisation in line with starting the drilling works.
Should you have any questions please comment on this page or contacts us at NWL.Customer@esh.uk.com.
Thanks
